Latest progress
Asphalt Binder Is Down.
On October 8, 2026, the binder course was down across the CDL training pad and the entrance drive, and masons were laying the block walls of the building beside it.
Project timeline
From Trees to Asphalt.
Every photo below was taken on the TCSG-411 site and is dated the day it was taken. Select any photo to see it full size.
-
June 4, 2026
Day One: A Wooded Lot.
Before any work began, the site was solid woods next to the Chattahoochee Technical College campus in Dallas.
-
June 8 to 11, 2026
Equipment Arrives and Clearing Begins.
The first excavator came in on a lowboy and clearing started. Timber was cut, stacked, and hauled as the ground opened up.
-
June 16 to 17, 2026
Clearing from the Air.
Drone photos show the cleared area growing behind the field office.
-
June 26 to July 10, 2026
Mass Grading.

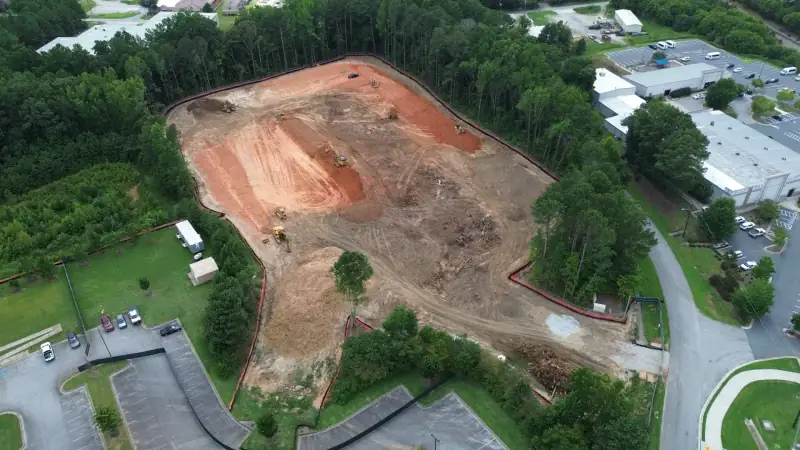

With the trees gone, crews cut into the red clay and began shaping the pad.
-
July 21 to August 27, 2026
Stone and Earthwork.
Stone went in along the site edge, and excavators, rollers, and dozers brought the pad to grade.
-
September 1 to 3, 2026
Building Footings.
Footings for the building were dug, staked, reinforced with rebar, and poured.
-
September 22 to 29, 2026
Curb, Conduit, and Stone Base.
Curb went in at the entrance drive, conduit went in the ground, and stone base covered the full pad.
September 22: curb going in at the entrance.
September 23: conduit in the trench.
September 29: the whole site, looking up the entrance drive toward the pad.

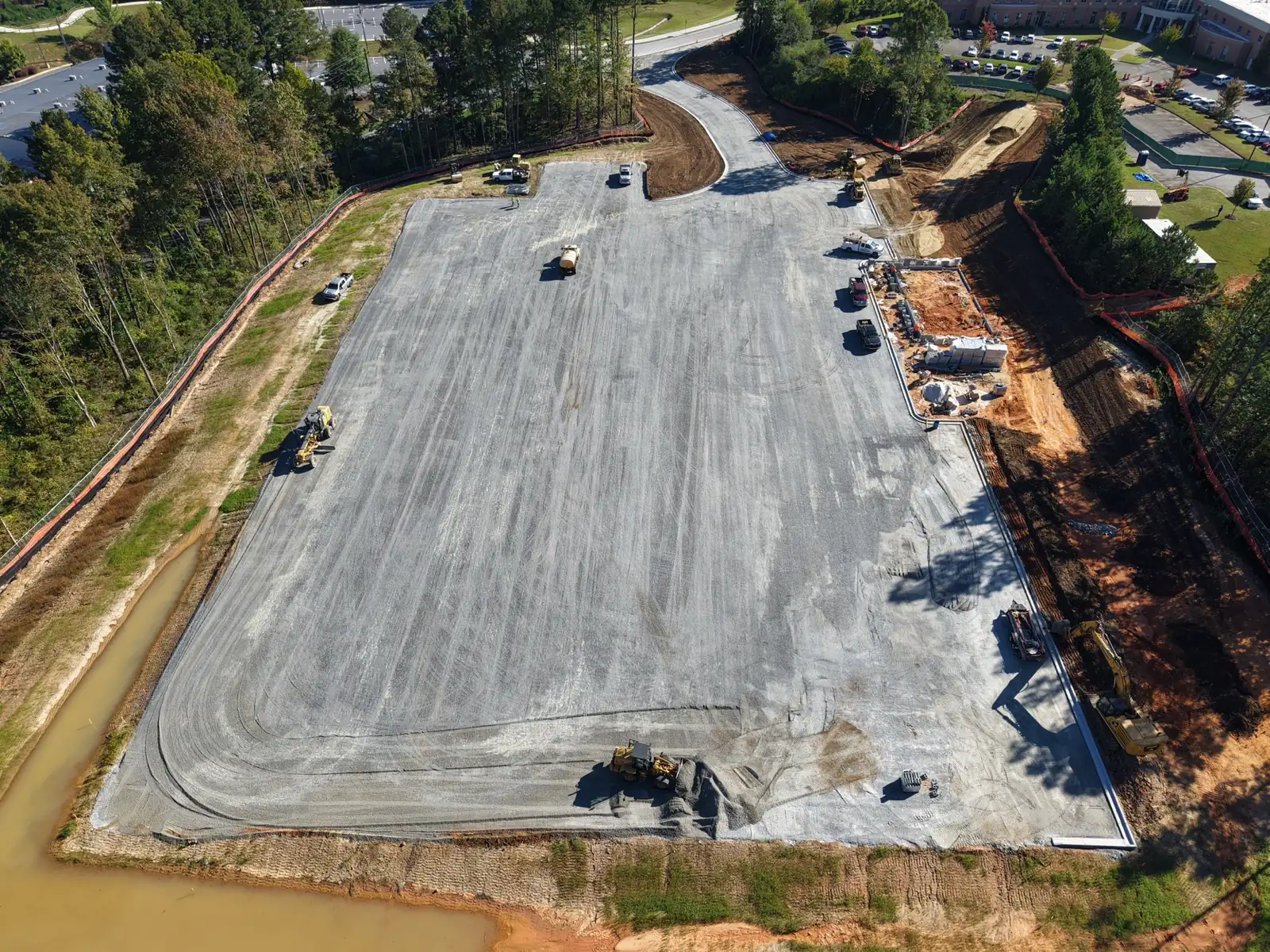

Stone base spread across the full length of the pad.

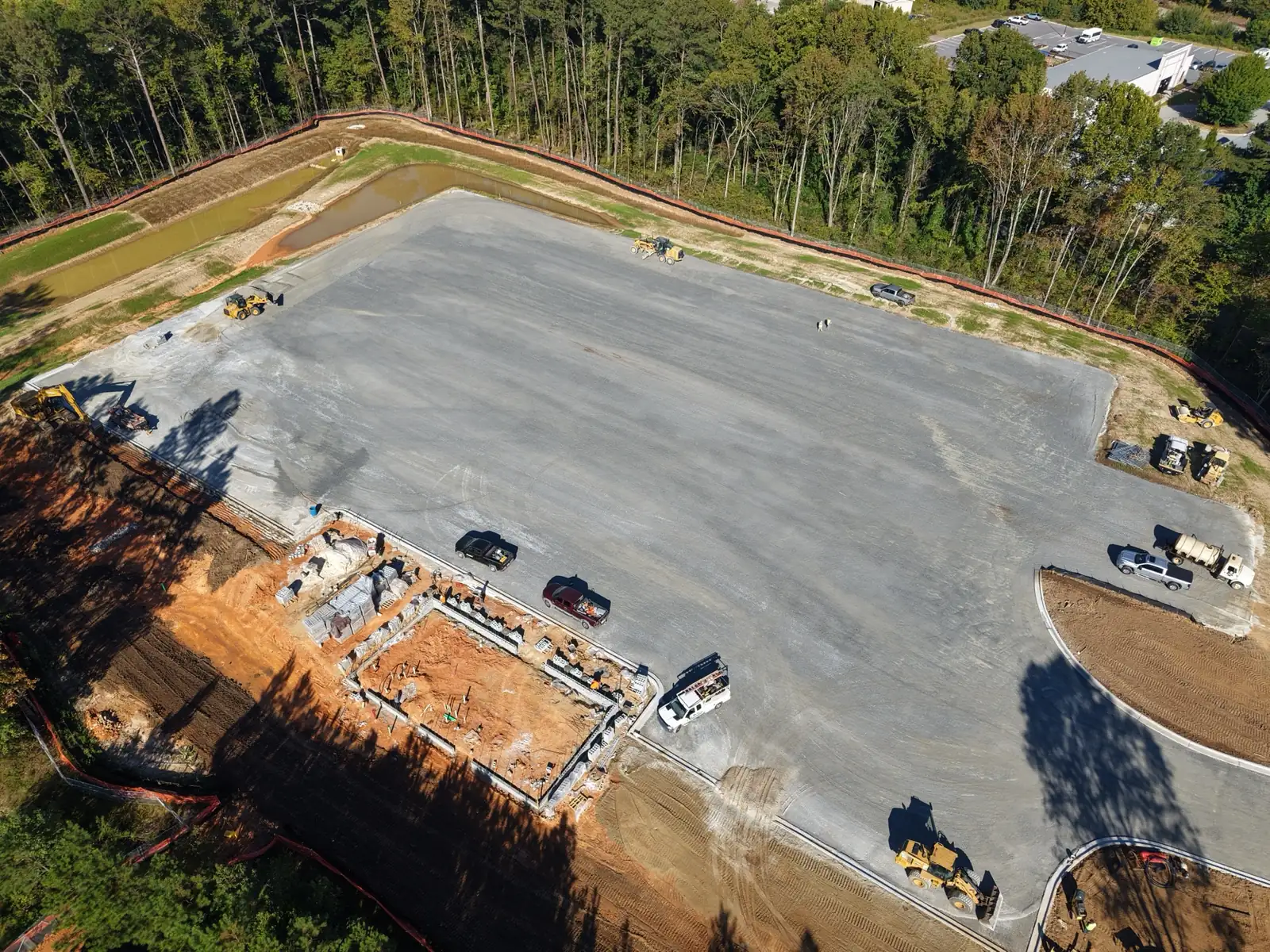

Building foundation at the edge of the pad.

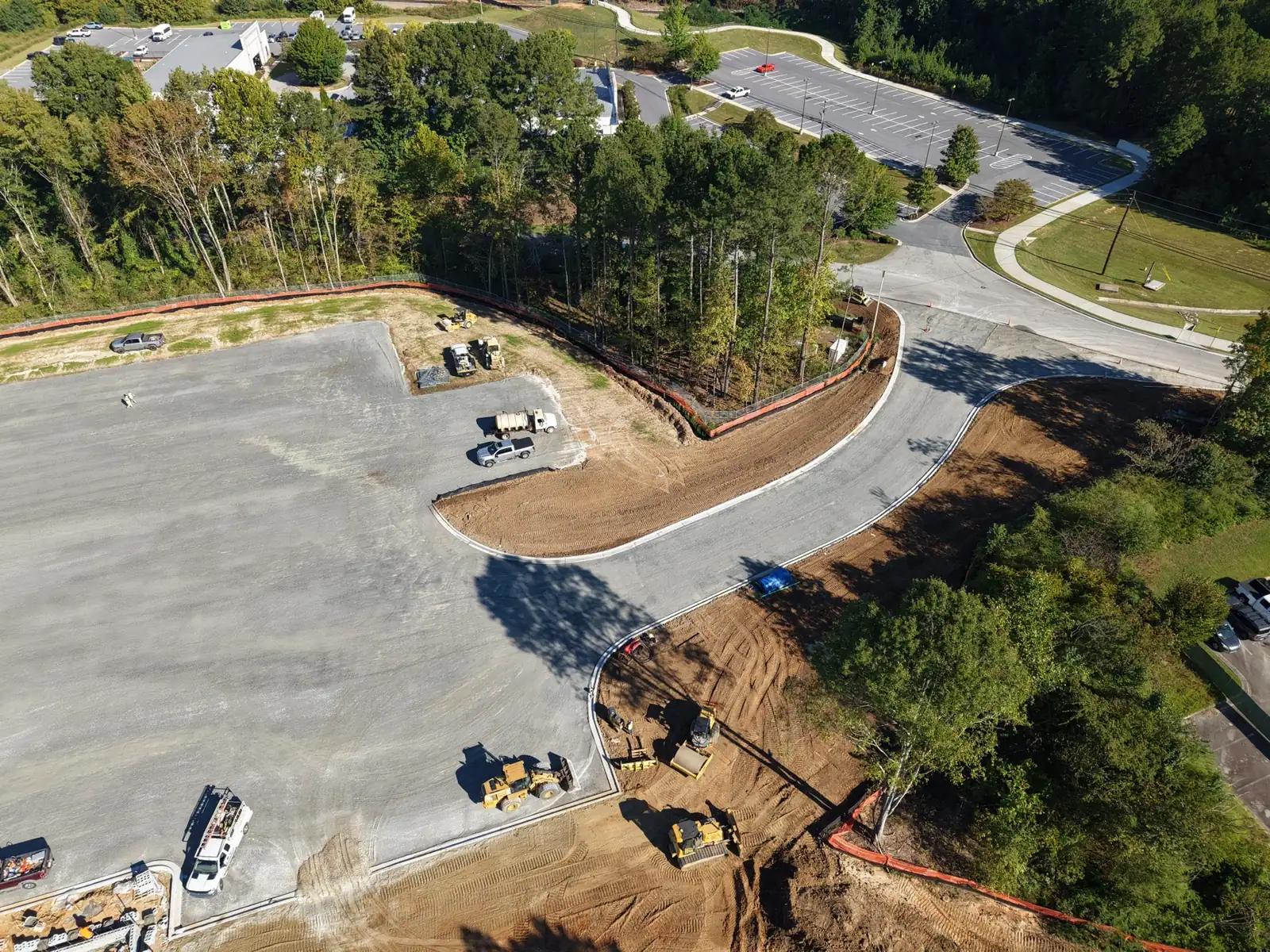

Entrance drive graded and curbed.

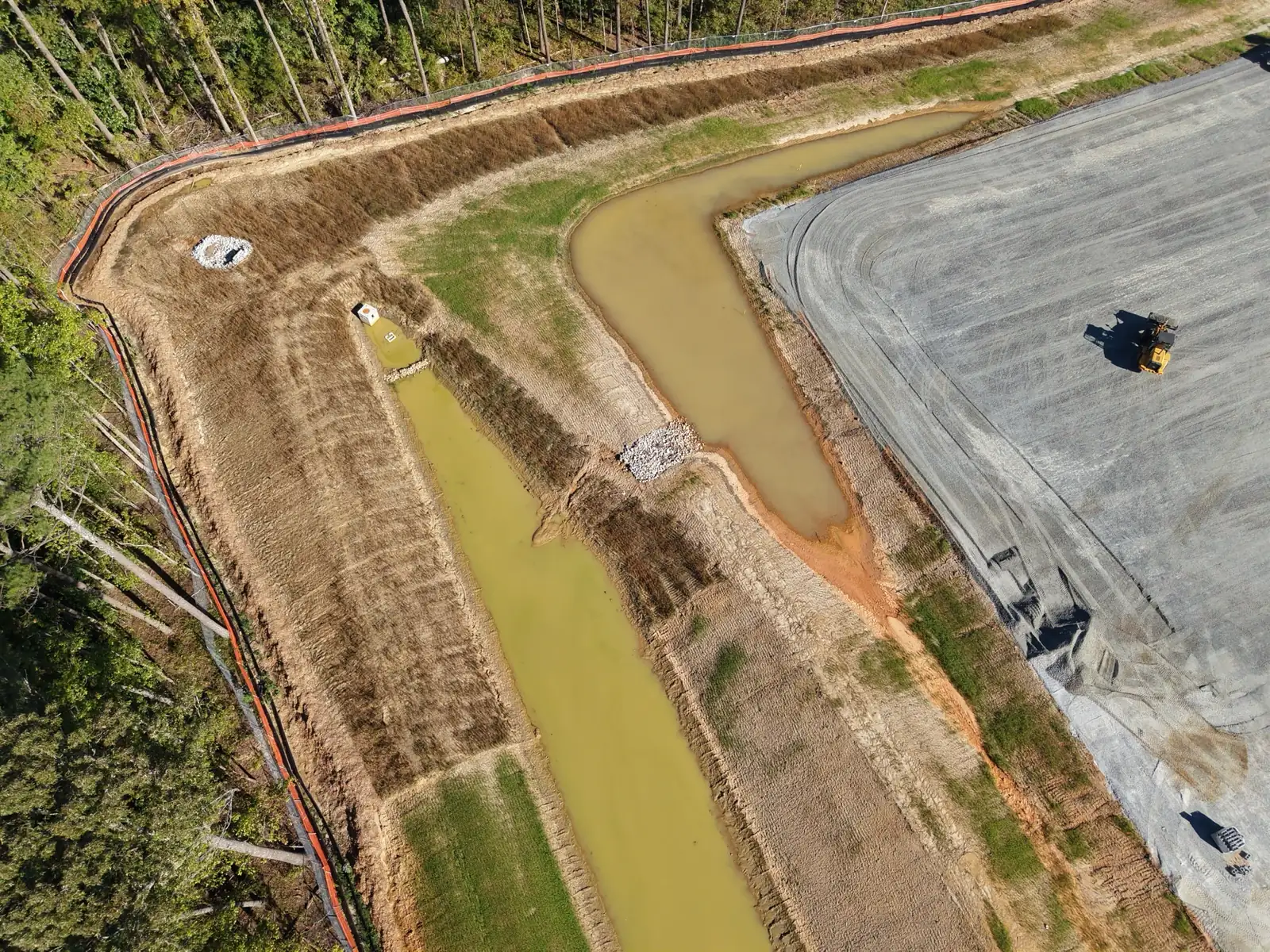

Stormwater detention with outlet structure and riprap. -
October 8, 2026
Asphalt Binder.
The binder course, the first layer of asphalt, is down on the pad and the entrance drive, and the building walls are going up.
On the Public Record.
The Technical College System of Georgia identifies TCSG-411 as Chattahoochee Technical College's new commercial truck-driving range in Paulding County. The Georgia State Financing and Investment Commission's construction-services chart also lists TCSG-411 in Paulding. The state's procurement event identifies the Dallas project, and its April 1, 2026 Notice of Award names Integrity CRR, LLC as the successful offeror.
The project is bonded, and the photographs on this page are from the site.
Prime-contract controls
What Integrity Manages on the Project.
A state design-bid-build project requires more than field production. Integrity's prime-GC responsibilities include trade coordination, submittal tracking, schedule updates, pay-application support, daily reporting, safety documentation, and coordination with the owner's representative and design team at required reviews and inspections.
Plan the Work
Sequence field activities against design requirements, approved submittals, access, and inspection points.
Coordinate the Trades
Manage subcontracted scopes under one prime contract and keep interfaces visible before they reach the field.
Maintain the Record
Keep schedule, progress, safety, submittal, and payment documentation aligned with the state program's cadence.
